Ptarmigan pointe

205 Stewart Creek Rise

– April 2025 – Deck topping, interior flooring and countertop installation (South Building). Ongoing mechanical and electrical rough-ins, roofing completed (North Building)

– May 2025 – Exterior siding installation, interior painting and mirrors (South Building). Insulation and drywall (North Building)

– June 2025 – Ongoing exterior siding work including window/door trim (South & North Buildings). Civil deep utilities installation including storm tank and site grading

– July 2025 – Shower glass, lighting fixtures installed (South Building). Ongoing carpentry finishing, cabinetry installation started (North Building). Overhead garage doors installed, asphalt driveway pours started

– August 2025 – Preliminary cleaning, deficiency reviews (South Building). Flooring, cabinetry installation completed (North Building). Exterior fiber cement siding and stone install completed. Ongoing install of exterior stucco and courtyard common area decking

– September 2025 – Window coverings installed (South Building). Appliances, shower glass, lighting fixtures installed (North Building). Surfaceworks nearly completed including sidewalks, curbs and gutters, landscape pavers, remaining asphalt driveways

100 Palliser Lane

– Town of Canmore Council approves the redesignation of existing direct control district on May 7, 2024. Permitting and tendering in progress, with construction set to begin in 2025

– Site Test Fit, Energy Modelling and Building Renderings complete – subject to change

– Prime Consultant – GGA Architecture

– Notice of Decision posted April 8, 2025. Construction expected to commence Q3 2025

– Groundbreaking Ceremony on September 16, 2025

Palliser Master Plan

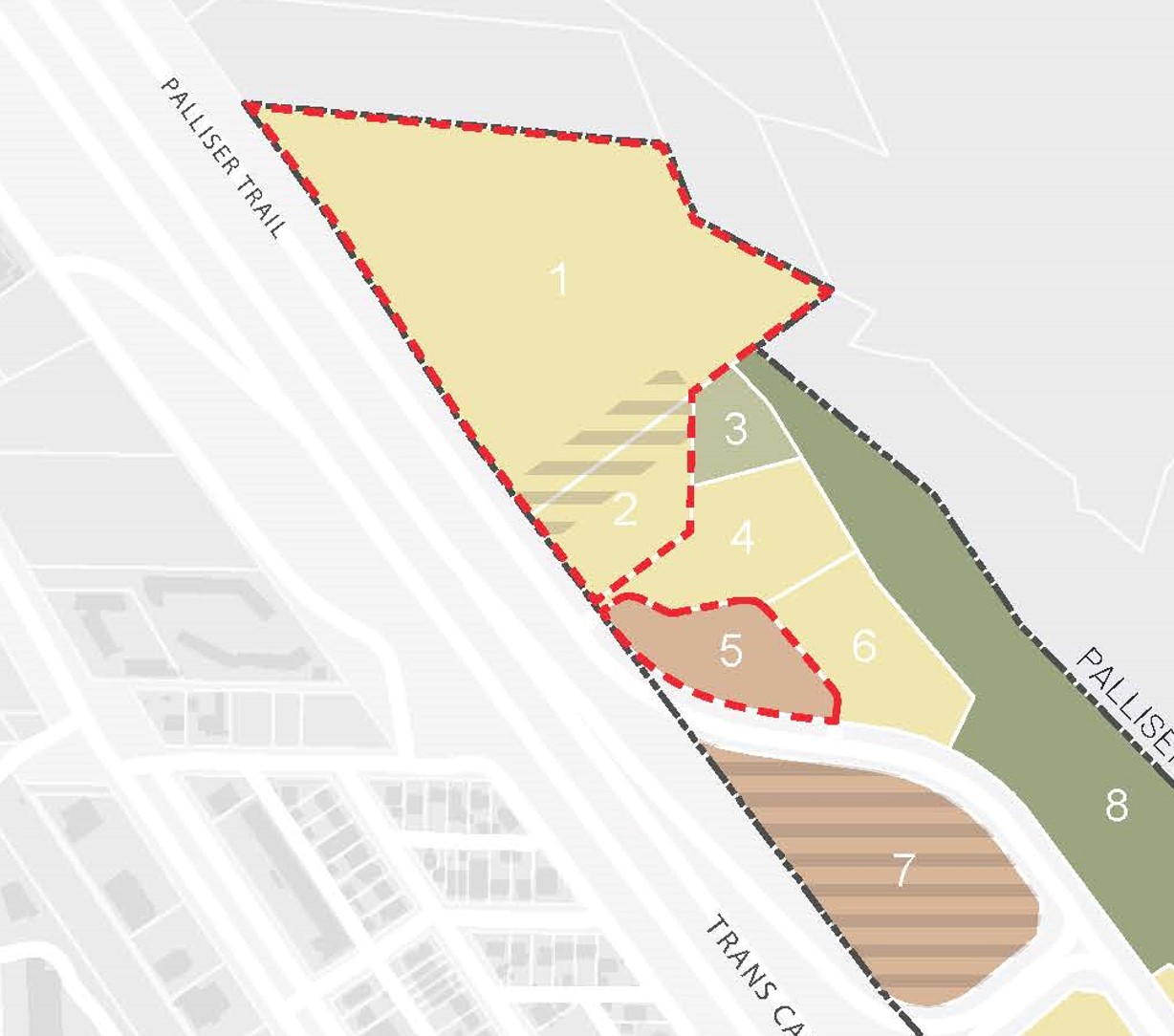

– Areas 1 & 2 of Palliser Trail Area Structure Plan

– Master Plan conceptual scenarios and high level proformas completed

– Subdivision application process to commence Q3 2025
